Build and use budgets

Objective. Use time, expense and billing budgets to forecast workload and revenue, compare forecasts with actual activity and prepare invoices without unnecessary re-entry.

Estimated duration1 h 15

What you will learn

  • Distinguish time, expense and billing budgets and understand how they complement each other.
  • Plan workload, billing dates and expected margins by client and matter.
  • Analyse variances between budgeted, actual and invoiced amounts.

Recommended workflow

  1. Define the scope, period, matter and assumptions before entering budget lines.
  2. Enter workload, expected expenses and billing schedules using stable reference codes.
  3. Review the forecast in the planning views and assign responsibilities where required.
  4. Compare the budget with actual time, expenses and invoices, then document material variances.

Before continuing

  • Every budget line belongs to the correct client, matter, period and issuing company.
  • Recurring budgets are renewed without duplicating existing lines.
  • A variance is explained from the detailed data before the forecast is revised.

Before you begin

Choose an open matter in your subscription with a billing budget and time budget. Record its fee, planned workload, employee and period. For example, an €850 fixed fee and four planned hours let you compare commercial value and workload without confusing them.

Prerequisites in your subscription

  • Use one matter from your subscription, its sales code, a planned task, the employee concerned and a comparable period.
  • Locate an existing budget for observation; do not run a global renewal or issue invoices during training.
  • Prepare four columns: forecast, actual, invoiced and explained variance.
  • Locate one billing-budget row, one time-budget row and the corresponding agenda week in your subscription. They must carry your exact matter, period, task and employee.

Suggested schedule — 1 h 15

  1. 5 min: translate the engagement into measurable assumptions.
  2. 15 min: build the matter budget.
  3. 10 min: schedule time, expenses and workload.
  4. 10 min: build the billing plan.
  5. 10 min: simulate renewal and check valuation.
  6. 20 min: reconcile forecast, actual and draft invoice.
  7. 5 min: step back and decide one management action.
Answer separately how many hours are planned, when they occur and how much will be billed. One global amount cannot manage all three.

1. Translate the engagement into three budgets

Open Clients / Matters > Budgets by matter and client. Treat time, expenses and billing as three related but different forecasts. Time answers what resources are needed; expenses anticipate external cost or re-billing; billing specifies commercial amount and date.

For your selected matter, record its billing amount for the period and its planned task hours for the selected employee. Do not force the figures to match: the commercial fee may be fixed while workload varies. Document the assumption, source and period so a future variance can be interpreted rather than merely highlighted.

Tempolia screenshot: budget by matter
The matter budget connects forecast, file, client and expected margin.

Tempolia screenshot: detailed time budget
Time budgets distribute planned work by period, task and employee.

Tempolia screenshot: billing budget by month
Billing budgets organise expected fees and due dates.

2. Turn time budgets into a workable schedule

Open the forecast agenda and position your matter’s planned hours in the intended week. Check existing workload, absences and deadlines. A budget says that work should happen; the agenda asks whether a named person can actually perform it at the right time.

If the week is overloaded, choose an explicit response: move the task, reassign it, change the deadline or renegotiate scope. Do not leave an impossible forecast merely to preserve the initial number. Keep the decision and reason with the budget so later reports distinguish a managed change from an entry mistake.

Open the selected week and check matter, employee, task and duration. If the expected row is missing, return to the budget, dates and filters before concluding on capacity.

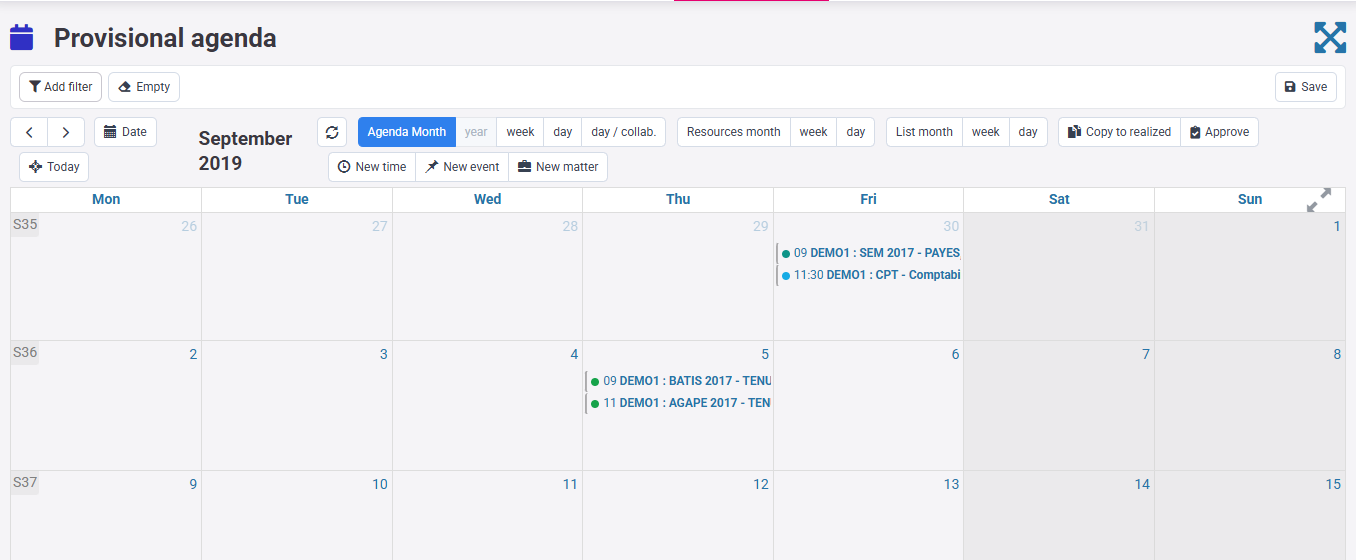

Tempolia forecast agenda for September 2019 with several DEMO1, BATIS and AGAPE workloads
Read the displayed workloads by matter and employee, then apply your own week and references.

3. Renew without copying old errors

The renewal form can reproduce time and billing budgets across a new period. Before any run, define source year, destination year, clients, matters, budget types and options. Preview the perimeter and search for destination lines that already exist. A renewal is a controlled proposal, not a blind duplication.

For this workshop, compare the selected matter’s engagement, rates, managers and scope with the source. Exclude obsolete tasks and revise dates. The expected result is exactly one intended line per destination period. If duplicates appear, stop; do not “clean up later” after other users have begun planning.

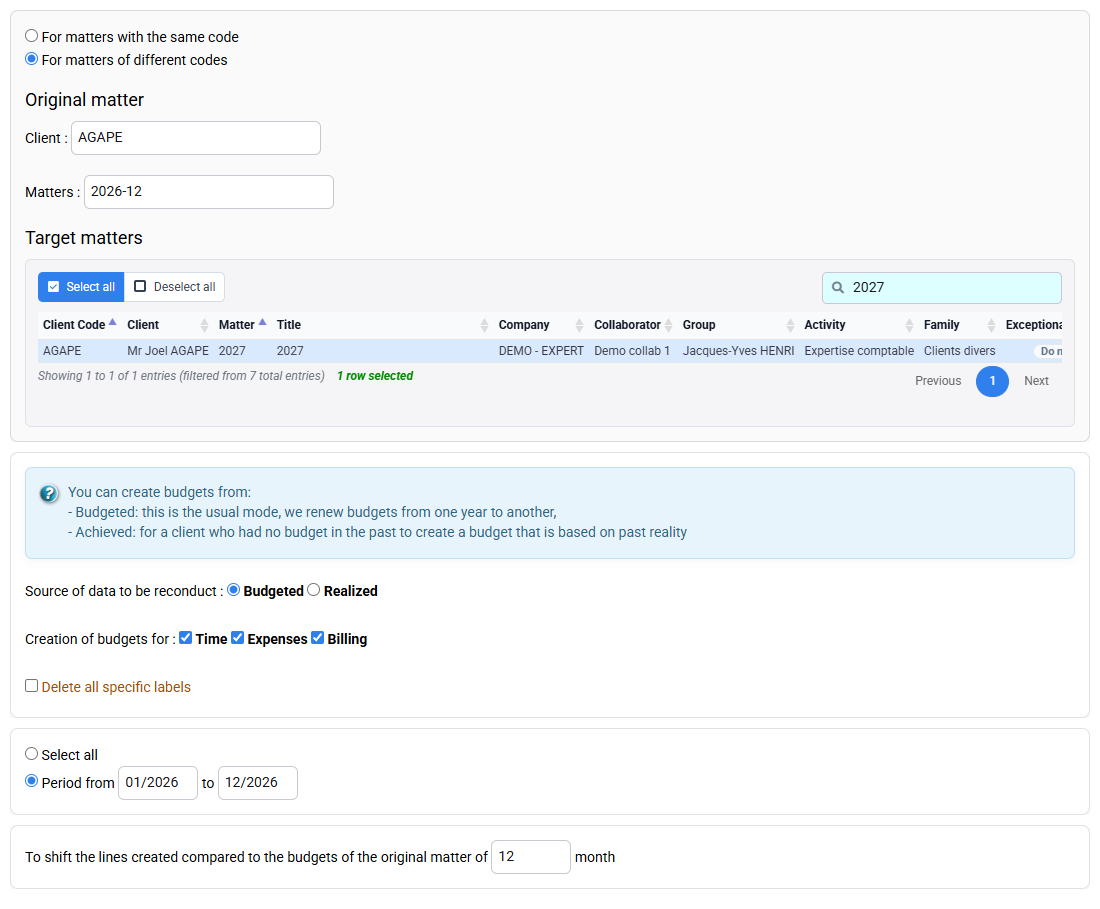

Tempolia screenshot: budget renewal form
The renewal form defines source, destination, perimeter and options.

4. Control valuation before interpreting margin

Time cost may come from compensation history; selling value may come from employee/matter prices or task quantity prices. Effective dates, matter-specific overrides and task rules decide which value applies. A correct duration with a wrong rate produces a convincing but false margin.

Check ACA’s relevant rate on 22 June and the price logic for REVISION. Keep internal cost and commercial price separate. If a report differs from the budget, establish whether the variance is quantity, mix of employees, rate, date or scope. Never adjust the budget solely to make the dashboard green.

The captured exception table contains no row. This proves only that no employee/matter override is observed there; identify the applicable general rule and effective date elsewhere before calculating any amount or margin.

Empty Tempolia employee and matter selling-price table
Negative evidence: no matter-specific override is shown. This screen does not identify or validate the general rate.

5. Compare forecast, actual and invoice proposal

Filter Time detail and Expense detail on your selected matter and period and the same statuses used by the budget. Compare hours, task, employee and amount. Then open invoice preparation without issuing: verify that the billing budget and eligible actual lines are not accidentally combined twice.

Example: if ACA records five hours against four planned, the one-hour variance is real; it does not automatically justify changing the fixed fee. Determine whether the cause is rework, scope change, learning, incorrect entry or unrealistic forecast. The business response may be operational, commercial or a future-budget revision.

Tempolia screenshot: actual time detail
Time detail provides the actual work compared with forecast.

Tempolia screenshot: invoice preparation from budgets
Invoice preparation shows how budget sources become a controllable proposal.

6. Build a decision-ready variance report

Use Reports / Outputs or a pivot table with the same company, client, matter and period. Display forecast hours, actual hours, forecast fees, invoiced fees and valuation. Group first by matter, then drill into employee and task. Save or document filters.

A useful variance statement contains four elements: measured difference, verified source, cause and action with owner. “Budget exceeded” is only an alert. “REVISION +1 hour because an additional bank reconciliation was requested; manager to review scope before July” supports a decision.

Filter the pivot on your matter and period, then compare planned and actual hours with the same unit.

Tempolia screenshot: budget control report form
The report form aligns period, axes and comparison columns.
Tempolia pivot table of real AGAPE time by employee
Use the matter and employee breakdown, then reconcile it with your own planned hours.

Hands-on budget review

  1. 1. Record your matter’s fee, planned hours, employee and period with their source.
    Time, date and commercial amount are explicit and separate.
    If not, return to the engagement and matter rather than inventing a number.
  2. 2. Place the hours in the forecast agenda and check ACA’s workload.
    The task has a feasible slot or a documented arbitration.
    If not, reassign, reschedule or renegotiate; do not hide overload.
  3. 3. Compare detailed time and expenses, budget and invoice preparation on one perimeter.
    Every variance and every proposed invoice line is explainable.
    If not, check period, status, already-invoiced flag, rates and matter.
  4. 4. Write one operational, commercial or forecast action with owner and due date.
    The budget review changes a decision, not merely a colour on a report.
    If not, distinguish an entry error from a genuine business variance.
Planned hours, actual hours, planned fee, invoice proposal and variance cause fit in one reproducible control sheet.

Errors to avoid

  • Using one global amount as time, capacity and billing forecast.
  • Renewing before checking destination duplicates and changed contracts.
  • Changing the forecast to conceal actual overrun.
  • Interpreting margin without checking rates and effective dates.
  • Comparing screens with different periods, matters or statuses.

Step back

A budget is a governed hypothesis. Its value comes from explicit assumptions, comparison with reality and documented decisions. Accuracy is not never changing the budget; it is knowing why, when and by whom an assumption changed.

Can you explain your matter’s planned workload, capacity, commercial fee, actual variance and chosen action without forcing these dimensions into one number? If yes, the budget is a management instrument rather than an archive.

Check another budget from forecast to billing

Choose a second matter and keep one table with forecast, actual and billed values. Do not move dates merely to make the figures agree.

  1. 1. Before opening Tempolia, write down budget amount, planned hours, period, responsible person, actual hours and amount already billed.
  2. 2. Read the budget first, then the matching time lines and finally the billing draft. Recalculate the variance and the completion rate before reading the report total.
  3. 3. Test one useful difference: duplicated renewal, overloaded employee, actual time above budget or a budget missing from billing preparation. Find the first screen where expected and observed values diverge.
  4. 4. Close every tab and repeat the route from your notes. Then give the notes to a colleague and let that person perform the same read-only check without oral help.
Your notes explain both the variance and the dated business decision that follows from it.
